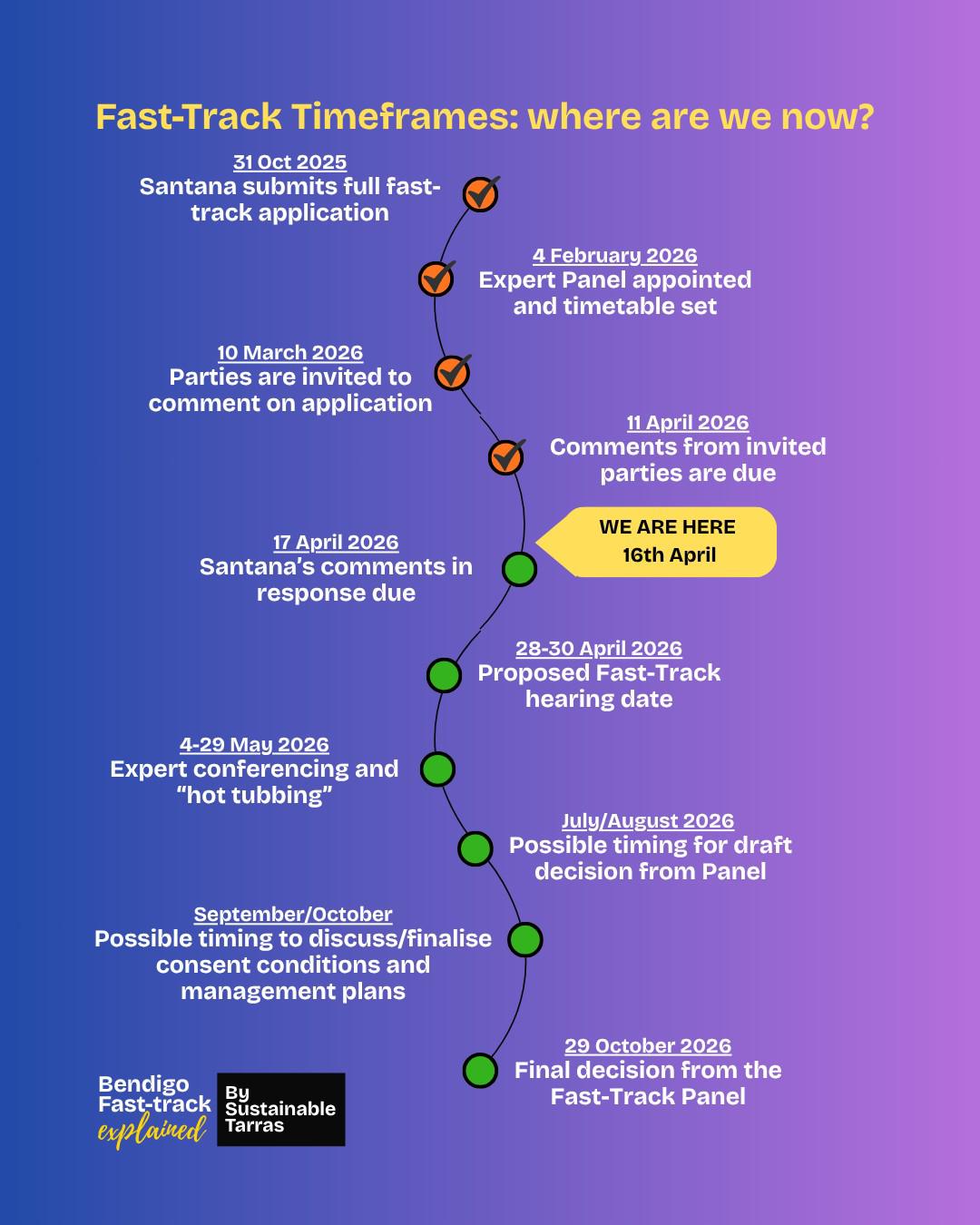

This just in from Newsroom, reporting on a possible pause in Santana's Fast-Track application

2 October 2026“It has been almost a year since Santana Minerals applied [...] In that time there have been two pauses in the processing of the application, due to additional information being required by assessors.

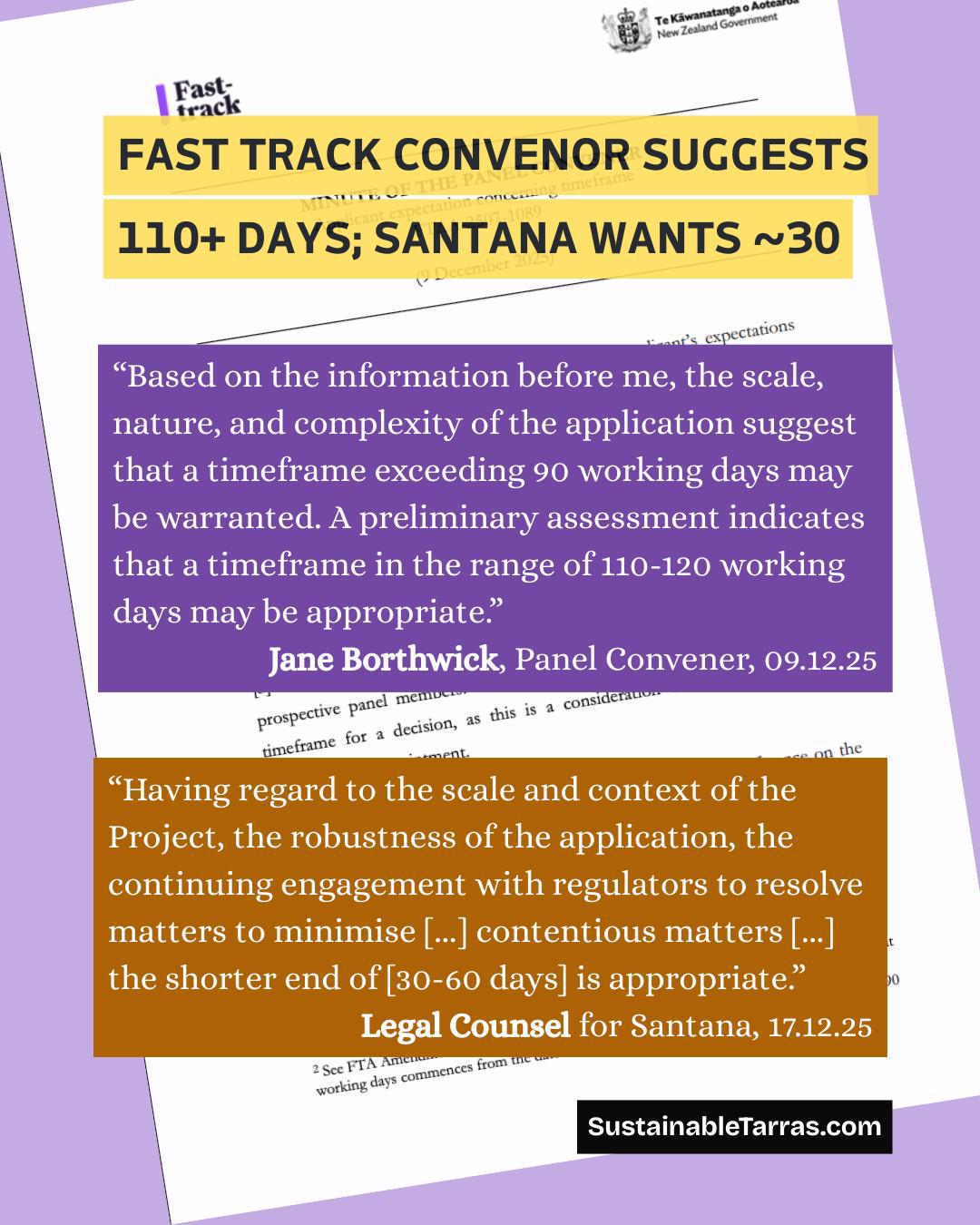

The [Fast-Track application] has cost $3.03m so far, senior communications advisor to the Environmental Protection Agency Jessica Rowley reveals to Newsroom. This figure includes central and local government costs and fees to the panel convener and panel members, all of which are recoverable from the applicant. Panel chair Matthew Muir KC gave Santana two days to advise how they could remedy unsatisfactory proposals that he believed did not ensure future public access to parts of the site. Complexities have arisen over land tenure and vehicular access due to conveyancing requirements and because part of the site is public conservation land. [...]
“The panel therefore invites Matakanui Gold Ltd to urgently consider how the necessary level of certainty is to be achieved,” Muir says. “If a satisfactory response is not possible within two working days, it further invites Matakanui Gold Ltd to request a processing pause until it is able to do so.” [...]

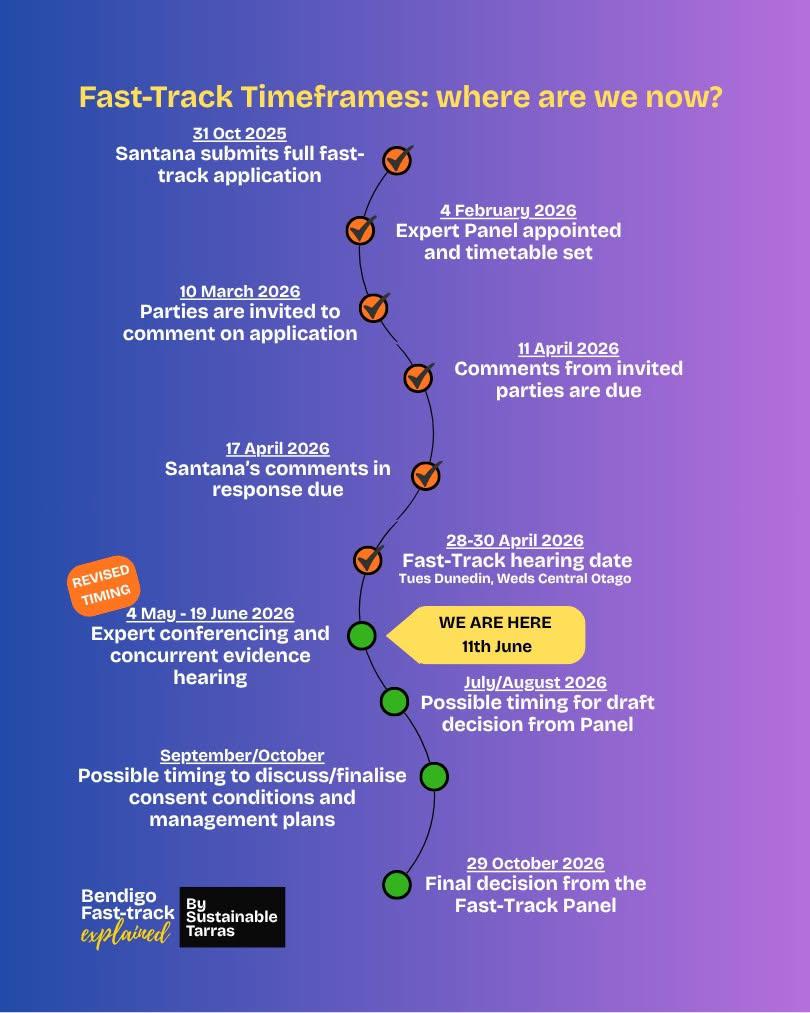

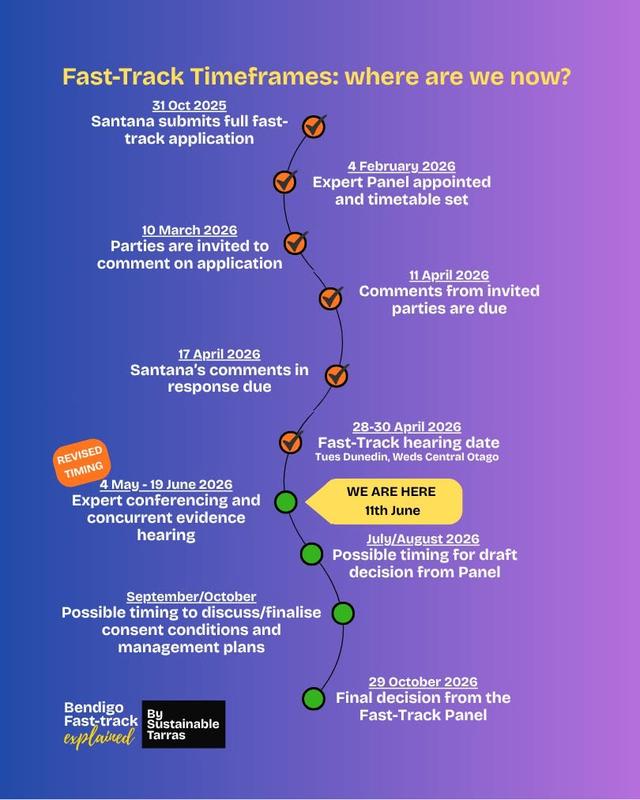

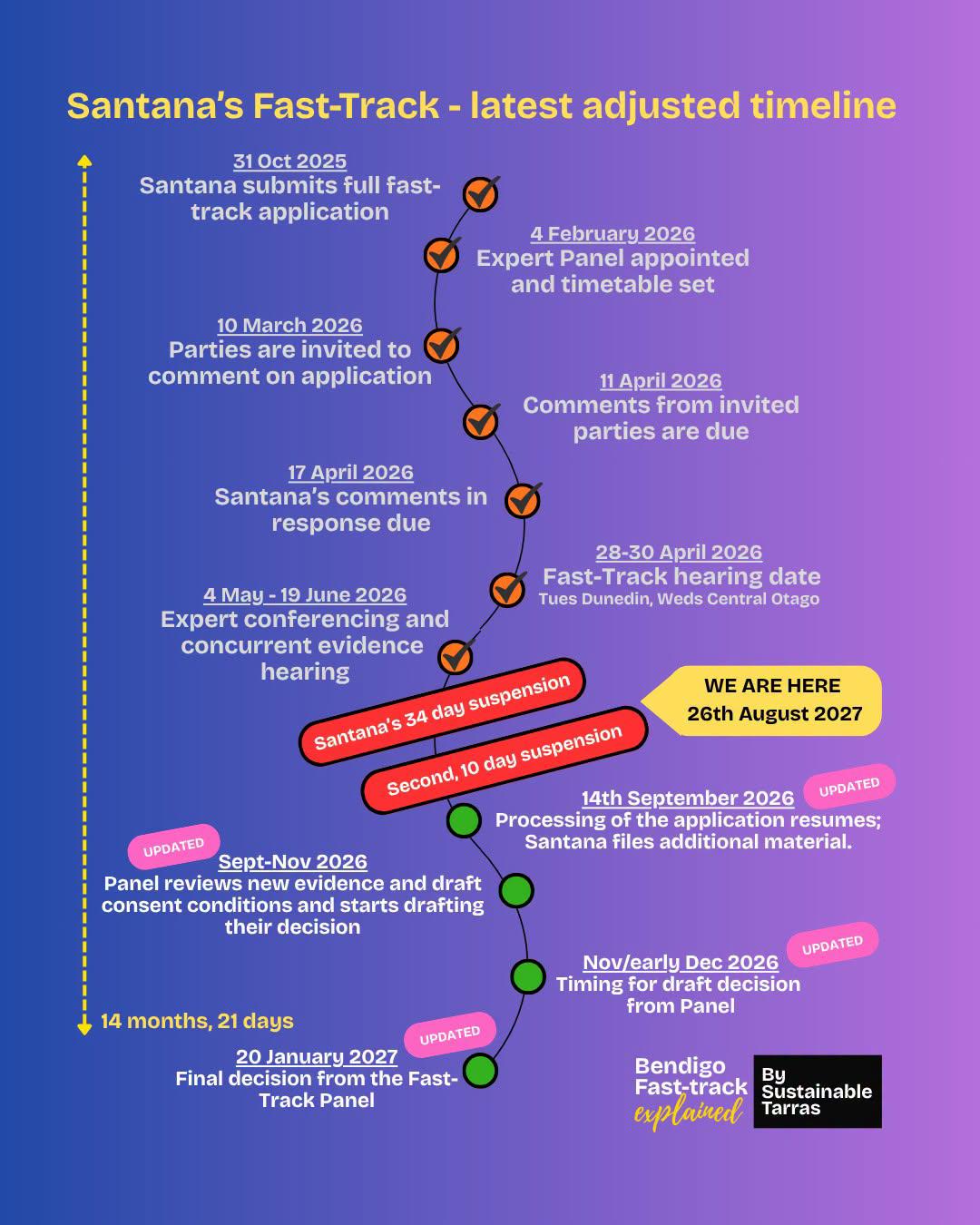

the project’s bunny-hop through the fast-track process has seen processing delayed twice due to requests for further information from the panel. https://newsroom.co.nz/2026/10/02/record-costs-blow-out-as-giant-central-otago-goldmine-fast-track-stalls-again/ All funds raised on this page will go towards our experts.
